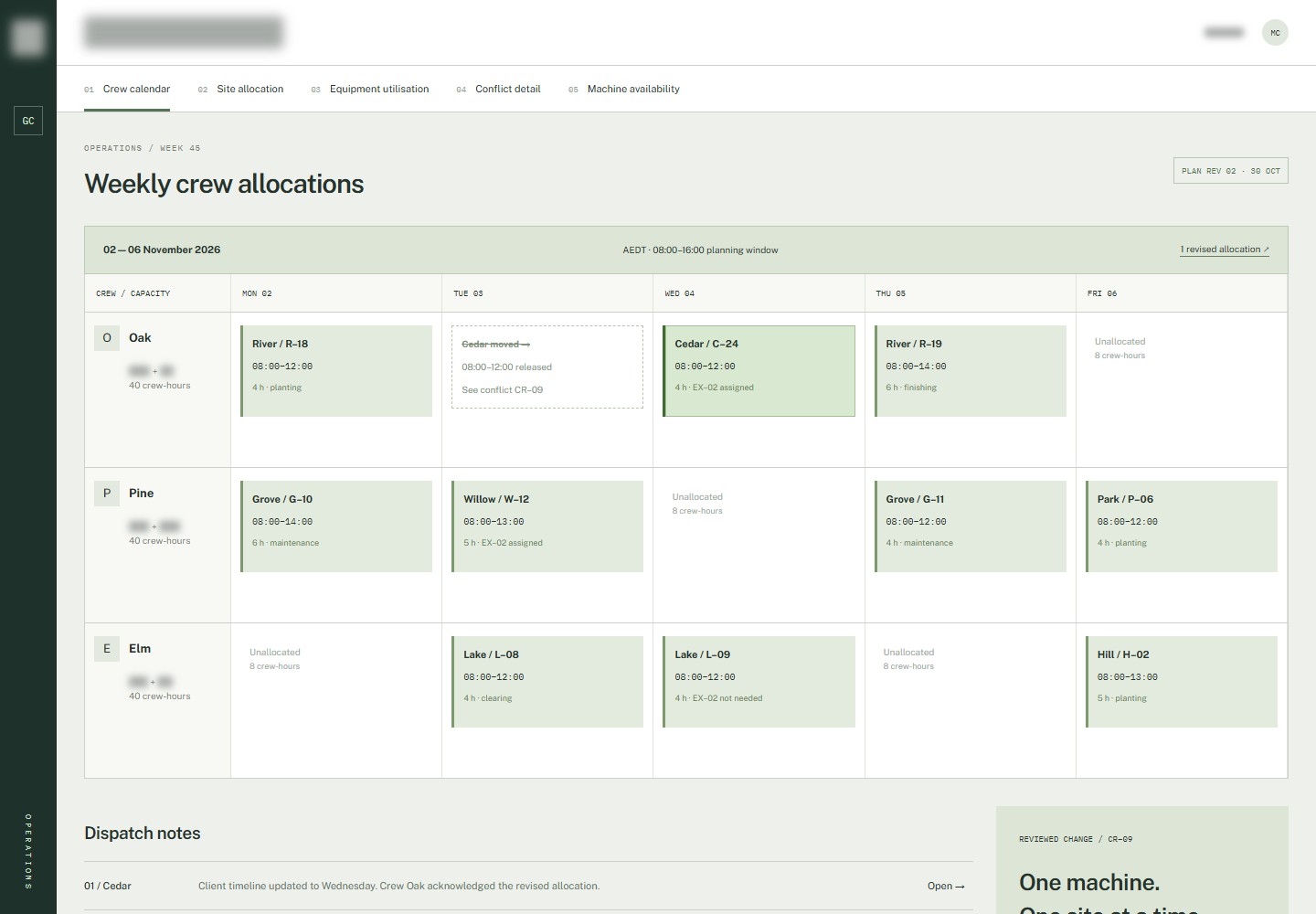

Weekly crew allocations
We built the landscape operations console around a working-week grid and machine-hour lanes.
View the screen ↓
We built the landscape operations console around a working-week grid and machine-hour lanes.

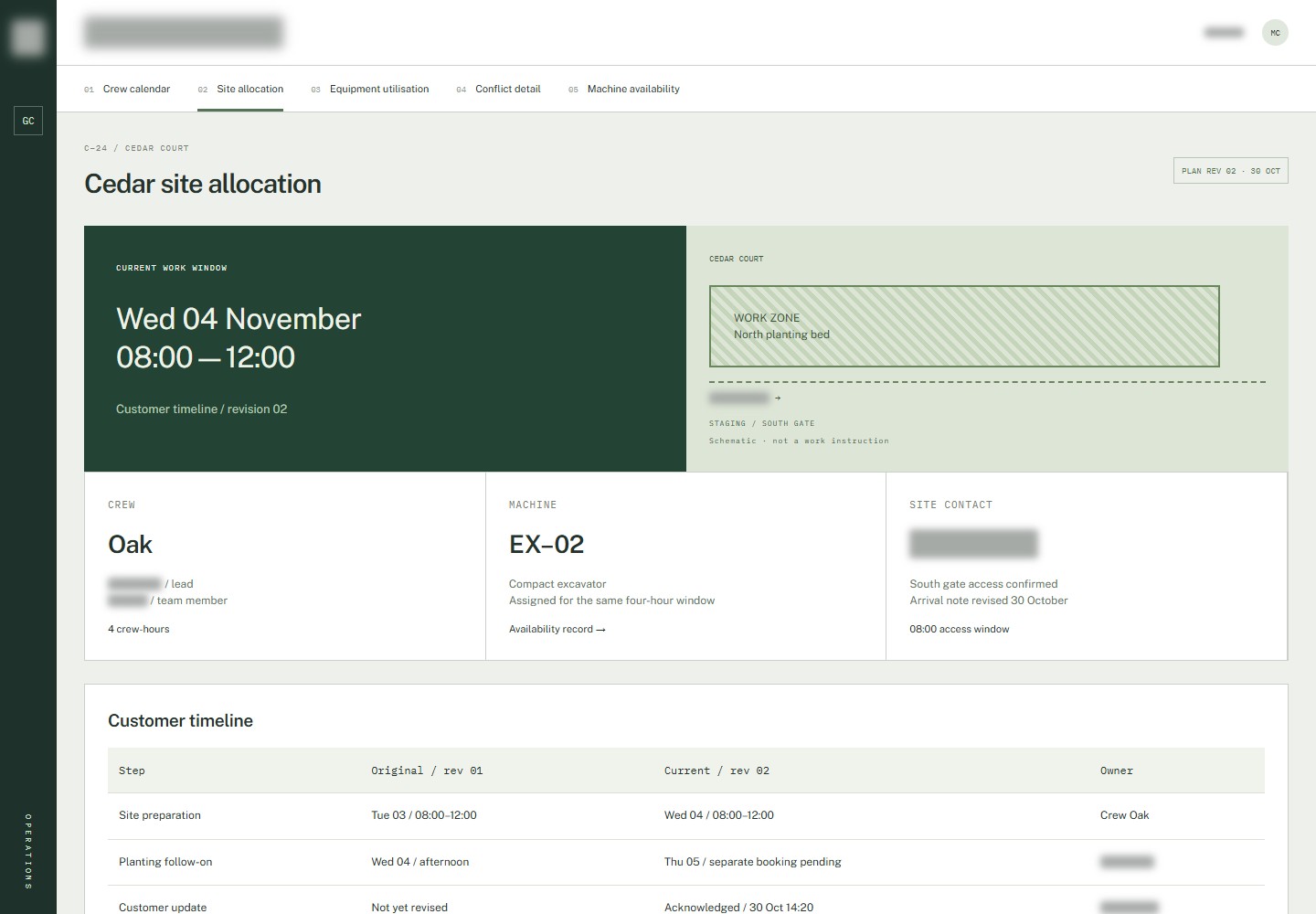

The site allocation connects the people assigned to a job with the equipment the job needs.
Weekly crew plans depend on shared machines as well as people. An overlap needs an explanation before either allocation can be treated as workable.

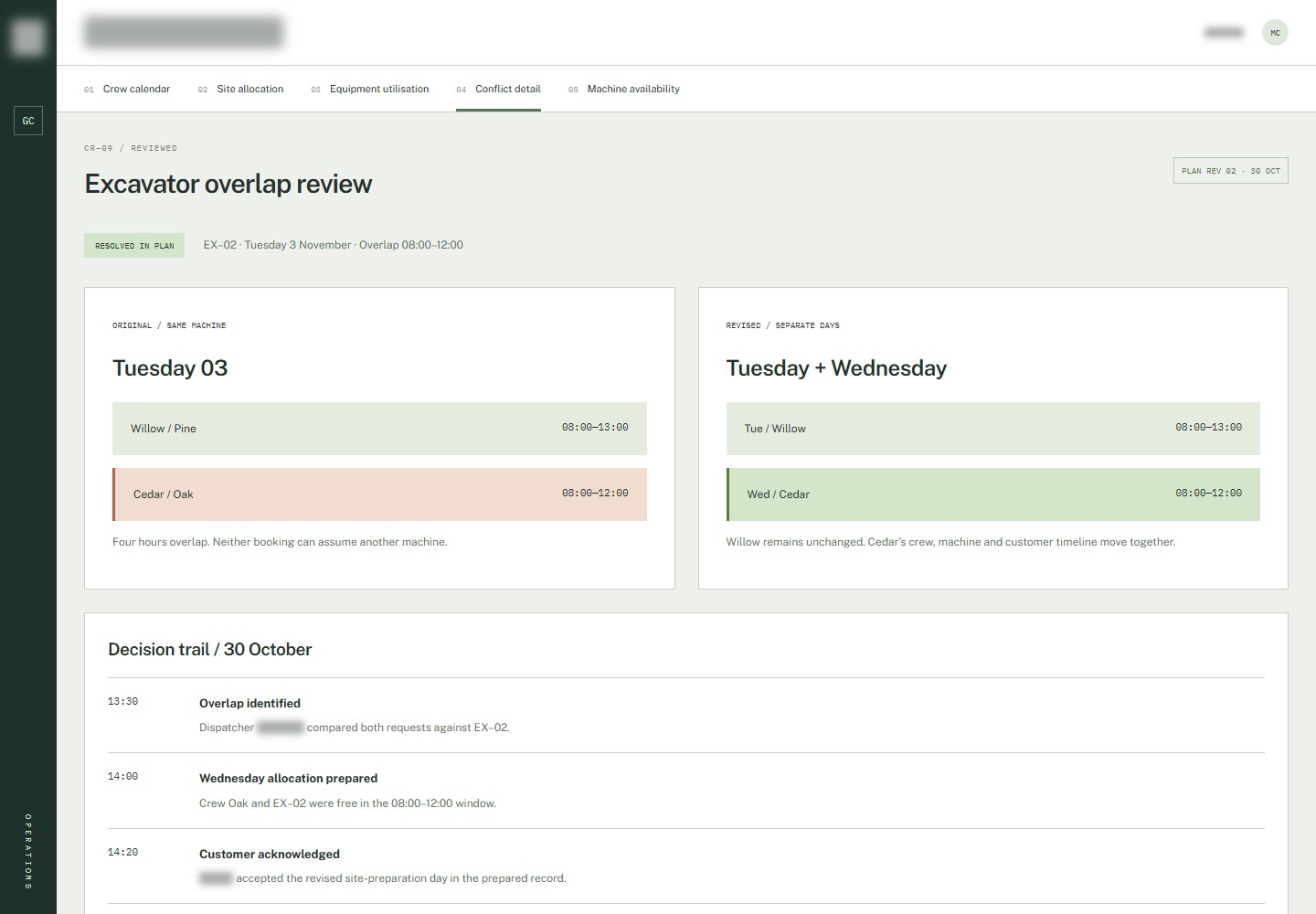

The overlap review and machine windows make the resource conflict explicit. We kept the interface compact because the coordinator is comparing allocations, not browsing a marketing page. The schedule illustrates the planning decision without dispatching a crew or reserving a machine.
The build brings weekly crew allocations, cedar site allocation, equipment weekly utilisation, excavator overlap review and machine availability windows into one workspace.

We built the landscape operations console around a working-week grid and machine-hour lanes.
View the screen ↓
Compact excavator Assigned for the same four-hour window.
View the screen ↓

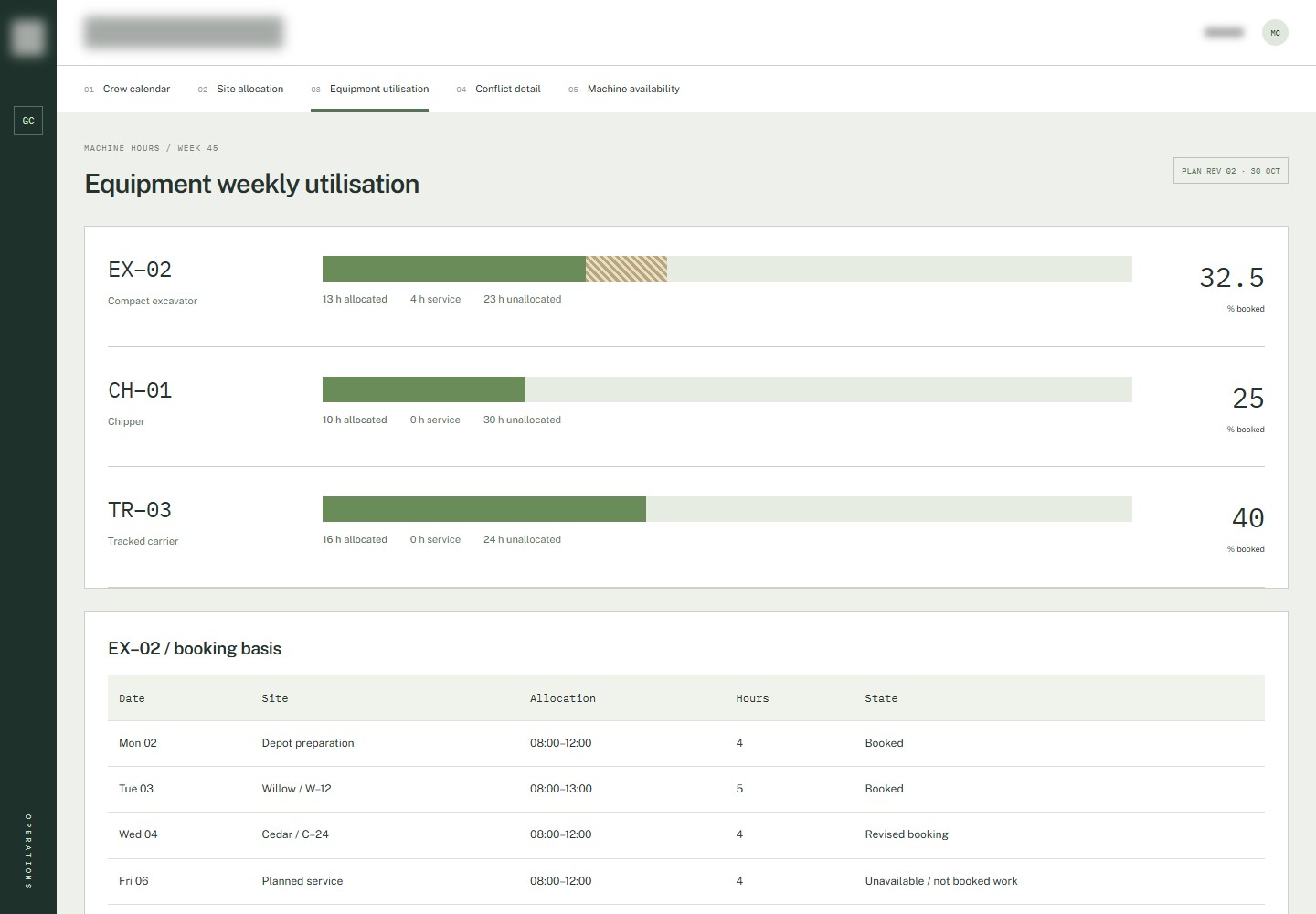

Shows equipment allocation alongside available capacity and planned work.
View the screen ↓
Four hours overlap. Neither booking can assume another machine.
View the screen ↓

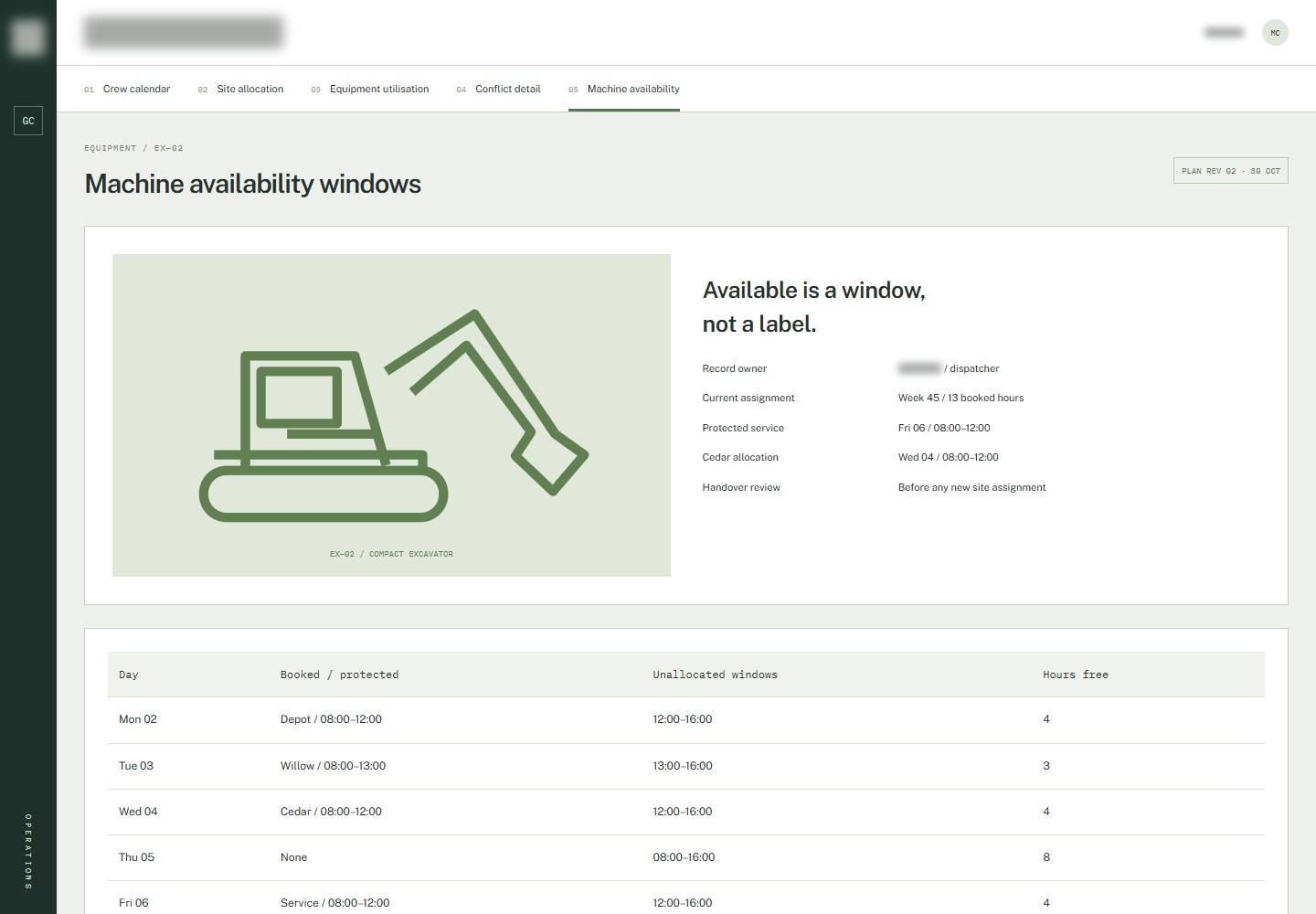

Presents machine availability and allocation in a shared equipment planning view.
View the screen ↓Explore the interface, from the first impression to the finer details.
Choose a view to enlarge ↓Tell us what your customers or team need to do. We can help define the pages, records and interactions around that task.
